Ensuite Bathroom Remodel in Melbourne: A Complete 2026 Guide

You've chosen the tiles, saved a few inspiration photos, and started wondering whether the old ensuite can really become the clean, practical room you want. Then the builder opens the wall and finds a misplaced drain, soft substrate or framing that won't accept the vanity you ordered. That's where an ensuite bathroom remodel stops being a simple cosmetic update and becomes a coordination job.

In Melbourne, the ensuite is usually the smallest and most cost-sensitive bathroom in the home. A 2026 price guide places a 3 to 4 m² ensuite at about A$16,000 to A$27,000, compared with A$24,000 to A$38,000 for a standard family bathroom and A$32,000 to A$54,000 for a main bathroom with a bath. Those figures from Melbourne renovation cost guidance make the central point clear: size, fixture count and layout decisions control the budget long before the tapware is selected.

The following approach is the one I'd use after decades on Melbourne renovation sites. Plan the room around its actual footprint, retain plumbing where it makes sense, sequence trades properly and treat waterproofing as a technical system, not a layer hidden beneath attractive tiles.

Planning Your Ensuite Before the First Demolition

A Brunswick couple once asked me to take over an ensuite after demolition had already started. They'd approved a design that moved the toilet, narrowed the shower entry and placed a wall-hung vanity against framing that hadn't been checked. The changes made sense on paper, but the existing floor structure and waste locations disagreed. By the time the layout was corrected, the project had accumulated A$6,800 in change orders.

That cost wasn't caused by one dramatic discovery. It came from several small decisions made before anyone measured properly.

Six questions to settle first

  1. How will the room work now, and how might it work over the next decade? A couple who currently uses the ensuite only at night may later need easier shower access, more storage or a safer floor layout.

  2. Who uses it? Children, guests and ageing parents place different demands on shower entry, vanity height, storage and door clearance. Design for the people who'll use the room, not only the person choosing the tiles.

  3. Which fixtures can stay within the existing plumbing footprint? Moving a basin a small distance may be manageable. Relocating a toilet or shower can involve floor framing, waste connections and access below, particularly in an upper-storey Melbourne home.

  4. What do the ceiling height and windows allow? Window placement affects mirror size, privacy and lighting. Ceiling height and available fall also influence whether a rain head is practical or whether a standard shower rose will perform more reliably.

  5. What is behind the walls? Shower walls may contain structural framing, services or awkward bulkheads. Don't assume a stud cavity is available for a niche or concealed cistern.

  6. Where is the budget ceiling? Decide whether the priority is durable waterproofing, better storage, premium glazing or decorative finishes. A fixed ceiling gives the builder a useful brief and keeps selections honest.

Measure the room before opening it

Record floor levels, door swings, window reveal depths, wall lengths and the position of every existing waste and water point. Photograph each wall and the floor before strip-out. Those images give the builder a baseline when old plasterboard, adhesive and fittings are gone.

Practical rule: Two weeks spent resolving measurements and selections can save weeks of rework once demolition exposes a 1990s bathroom's hidden conditions.

The Melbourne cost guide for bathroom renovations places smaller bathrooms under 5 m² in a broad historical range, but the useful lesson isn't a fixed allowance. It's that layout retention, waterproofing, tiling, plumbing and concealed defects matter more than choosing an expensive-looking finish.

Layout and Space-Saving Design for Small Ensuites

A 3 to 5 m² ensuite needs a layout with very little wasted movement. Start by drawing the door swing, shower entry and vanity depth at full scale. If the door consumes the centre of the room, the most beautiful fittings won't make the space feel comfortable.

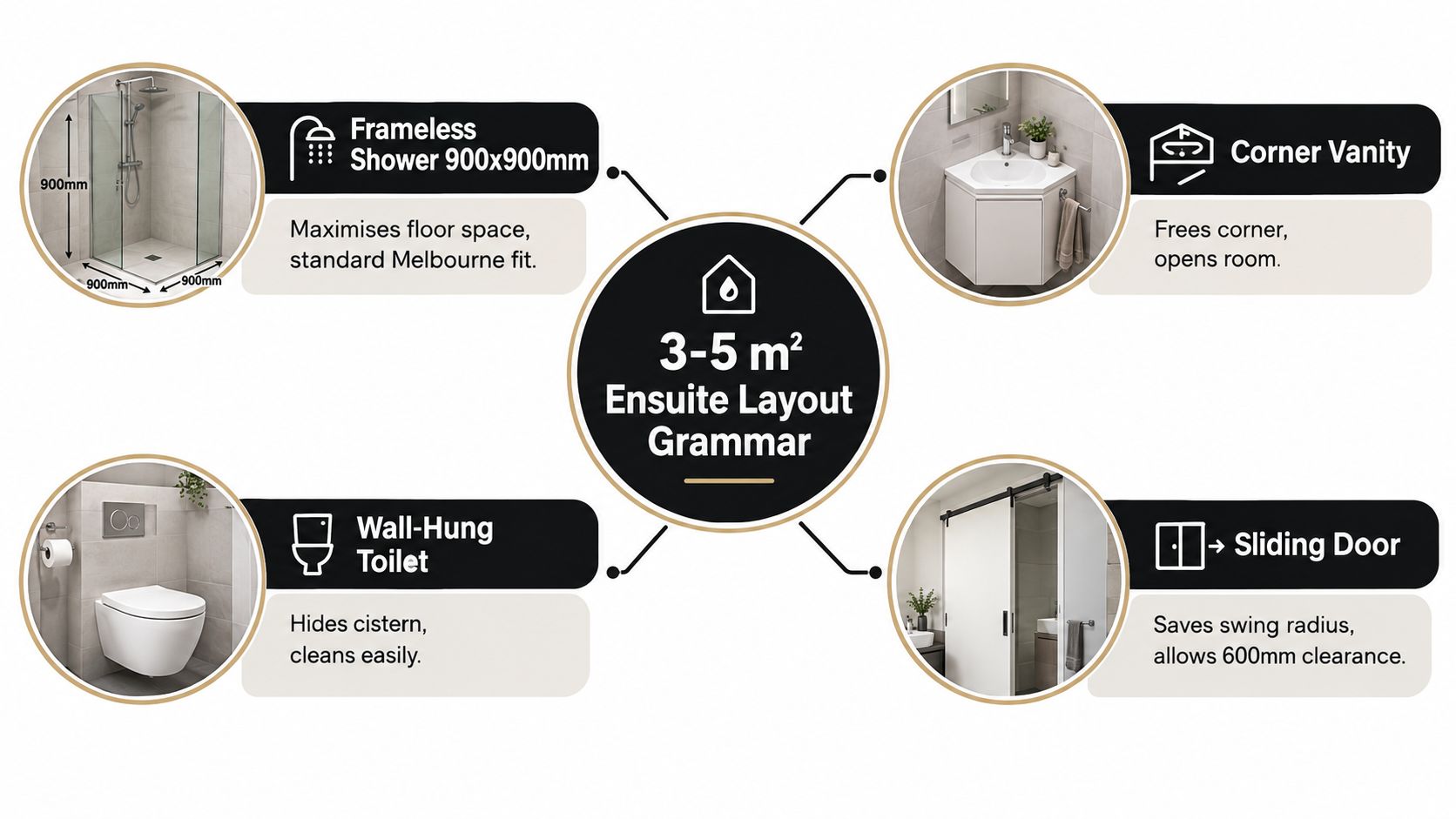

An infographic showing four essential space-saving design tips for a small 3-5 square meter ensuite bathroom layout.

Put floor area where it matters

A 900 by 900 millimetre frameless shower is usually the practical winner over a bath in a secondary ensuite. It provides a usable shower zone without introducing the bulk of a tub, and frameless glass keeps sightlines open. A wall-hung vanity with a 600 millimetre carcass leaves the floor visually and physically clearer than a deep freestanding cabinet.

For drainage, I favour a 150 millimetre lineal grate against the back wall where the floor structure and waterproofing design allow it. It supports a cleaner tile layout and removes a central drain from the main walking path. The grate still needs correct falls and compliant membrane detailing, so it isn't a shortcut around preparation.

Treat the door and storage as part of the plan

If the door swing takes around 1.5 square metres of usable floor, a pocket door or cavity slider can transform circulation. A surface-mounted sliding door may be suitable where a cavity can't be formed, while a cavity slider needs the wall framing and services checked before demolition.

Storage should follow a hierarchy:

  • Mirrored shaving cabinet: Include internal power where permitted and practical, so chargers and grooming appliances don't occupy the vanity top.
  • Recessed niche: A 300 millimetre niche between studs can hold bottles without adding a shelf into the shower.
  • Full-height linen storage: The wall behind the door often offers better storage potential than a larger vanity, provided the door hardware and clearances are coordinated.

A ceiling rain head can feel luxurious, but it needs sufficient water pressure, ceiling access and a practical fall for the supply. A standard rose is often the safer choice where the ceiling is low or the pipe route is constrained. For finishes, 600 millimetre large-format tiles reduce the number of visible grout lines and can make a compact room look calmer, although the substrate must be flat enough to support them.

Budget Brackets in AUD for Melbourne Ensuites

A small Melbourne ensuite can stay within a controlled budget when its plumbing points remain in place. Move the toilet, shower waste or vanity services, and the quote rises through extra demolition, pipework, patching and inspection work. The following planning bands describe complete project scopes rather than fittings alone. Published bathroom remodelling cost guidance also shows why inclusions matter more than headline figures.

BracketPrice Range (AUD)ShowerVanity & BenchtopTiles & FinishesExtras
BasicA$18,000 to A$25,000Standard acrylic shower baseLaminate vanityMid-range tiles, selected wall areasClose-coupled toilet, standard tapware
Mid-rangeA$28,000 to A$42,000Frameless glazingWall-hung vanity with stone topLarger-format tiles, full-height shower-zone tilingUpgraded tapware, improved accessories
PremiumA$48,000 to A$75,000Custom shower treatmentCustom joineryFull slab feature wall and selected luxury finishesFreestanding bath, in-floor heating, designer fixtures

The basic bracket generally suits a compact room with existing plumbing locations and straightforward access. It can cover competent demolition, replastering, compliant waterproofing, standard fixtures and mid-range finishes. It leaves little allowance for structural changes, difficult access or custom fabrication.

The mid-range bracket pays for sharper detailing and more involved installation. Frameless glass requires accurate finished dimensions, so walls and floor levels must be right before the glazier measures. A stone-topped wall-hung vanity may need reinforcement behind the lining, and the extra preparation increases labour because tighter finishes allow less tolerance.

Premium work involves coordination as well as expensive materials. Custom joinery, slab handling, designer fixtures, in-floor heating and structural changes each add decisions, sequencing and trades. In a small ensuite, a feature wall or concealed cistern can also require careful service planning because there is less room to hide errors.

Allow a contingency for conditions that cannot be confirmed before demolition. These items commonly shift the final bracket:

  • Older-home testing: Asbestos testing may be needed in pre-1990 homes before suspect materials are disturbed.
  • Wall reinforcement: Wall-hung vanities and some concealed cisterns require framing work before sheeting.
  • Electrical capacity: Heated towel rails and other upgrades may require work beyond a simple replacement.
  • Hidden defects: Rotten flooring, failed substrates and damaged plumbing appear only after strip-out.

Get each quote to state demolition, waste removal, waterproofing, tiling, fixtures, electrical work, painting and testing separately. That comparison exposes exclusions before the first trade arrives.

Trade Order and Guaranteed Timeline

A reliable ensuite programme is a sequence, not a collection of trades arriving whenever they're available. The timeline below is a controlled example. It depends on selections being approved, materials arriving and no concealed defect requiring redesign.

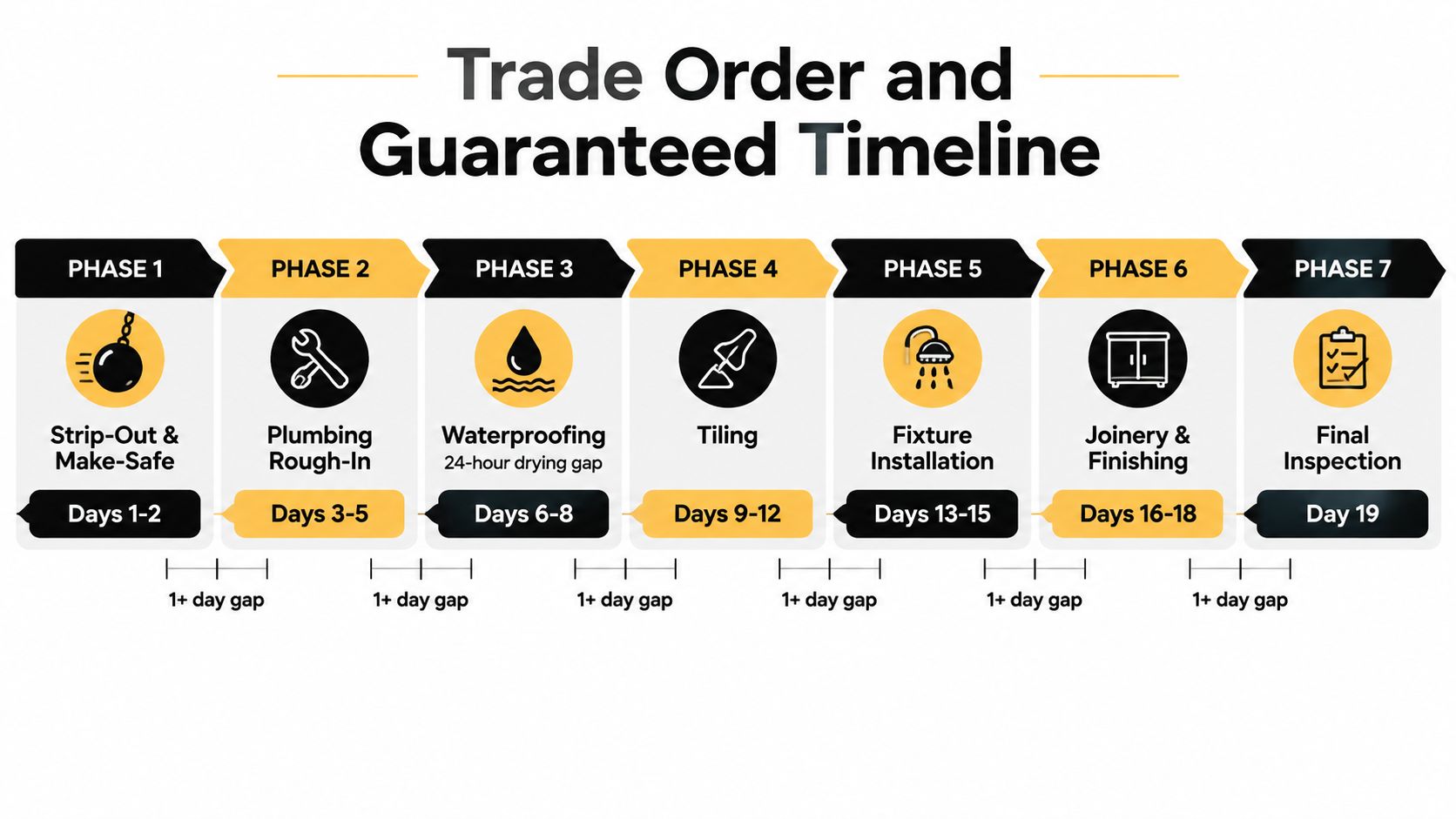

A detailed timeline infographic for a bathroom remodel project showing seven phases from strip-out to final inspection.

The order that protects the finish

  • Days 1 to 2, strip-out and make-safe: Isolate services, remove fittings, protect adjoining rooms and expose the substrate. Photograph conditions and identify anything that differs from the approved plan.
  • Days 3 to 5, plumbing rough-in and electrical first fix: Set waste positions, run water services and place electrical conduits before the walls close. Pressure-test plumbing before sheeting.
  • Days 6 to 7, wall sheeting and screeds: Install approved wet-area linings, prepare the floor and form falls to the waste. Check the shower threshold and door relationship now, not after tiling.
  • Days 8 to 9, waterproofing: Apply the membrane to the specified wet zones, reinforce corners and seal penetrations. Allow the required 24-hour cure period before the next operation.
  • Days 10 to 14, tiling and grouting: Set out the walls and floor, cut around wastes and niches, then grout only after the adhesive has cured as required by the product.
  • Days 15 to 17, fit-off: Install glass, vanity, toilet, tapware, accessories and electrical items. Protect finished surfaces while the final connections are made.

The homeowner should receive a waterproofing inspection certificate, see the screed fall test, and confirm that plumbing has been pressure-tested before walls are closed. Keep a buffer for tile delivery, custom glass lead times and Melbourne's stop-start weather, particularly where access or curing conditions are affected.

The sequence matters because waterproofing can't be tiled over before it has cured and been checked. Glass can't be measured accurately until the finished walls and floor are in place. Joinery shouldn't be installed while dusty demolition or wet adhesive work continues.

For another perspective on programming, see this guide to how long a bathroom renovation takes.

A short visual explanation of the work sequence can also help during a consultation.

Waterproofing and Compliance in Australia

Waterproofing is where an ensuite remodel earns its durability. In Australia, the relevant framework includes NCC 2022 Part 10.2 and AS 3740:2021, with requirements that apply according to the wet-area configuration, floor construction and fixture locations. The NCC 2022 wet-area waterproofing provisions specify the core shower-zone requirements.

LocationMinimum RequirementCompliance Standard
Shower wallsWaterproof to at least 1800 mm above the finished floor substrate, or 50 mm above the shower rose if higherNCC 2022 Part 10.2 and AS 3740:2021
Shower floorFully waterproofedNCC 2022 Part 10.2 and AS 3740:2021
Wall and floor junctionsProtected and sealed as part of the wet-area systemNCC 2022 Part 10.2 and AS 3740:2021
Timber-based wet-area floorsEntire floor waterproofedNCC 2022 Part 10.2 and AS 3740:2021

Falls and membrane coverage

The shower floor needs to direct water to the waste without pooling. Australian renovation guidance commonly uses gradients around 1:80 to 1:50, depending on the shower arrangement and drainage design, as explained in waterproofing and tiling guidance. The room category matters. A bathroom floor may be water-resistant rather than fully waterproof in some configurations, while a timber-based wet-area floor has broader membrane requirements.

Map the wet zones before the applicator starts. Mark the shower, bath if present, step-downs, junctions and penetrations. Pre-formed shower bases can change how the floor and wall junctions are detailed, but they don't remove the need to follow the approved installation method.

The shortcuts that create disputes

A membrane that stops short of the required shower height, an unsealed pipe penetration or a missing full-floor membrane on a timber floor can leave water paths behind the tiles. Incorrect falls create pooling, while poorly sealed junctions can transfer moisture into adjacent framing.

Use a licensed and properly qualified waterproofing professional, and keep the method statement, product details, inspection record and certificate in the project file. A plumber may also perform waterproofing, but the relevant competency, documentation and installation method must be clear. For a technical contractor discussion, bathroom waterproofing in Melbourne provides useful context.

The same discipline applies to porous finishes and stone. If you're considering a marble vanity top, review practical marble countertop maintenance tips before choosing the material, because ongoing sealing and cleaning form part of the ownership cost.

Common Pitfalls and Cost-Saving Strategies

Most ensuite budget blowouts begin with decisions made before the builder arrives. A homeowner selects a new fixture position, orders a special tap and changes the tile halfway through the job. By then, the trades have priced and built around a different set of assumptions.

Five traps that cost more than they save

  • Moving the toilet or shower without checking structure: Waste locations and floor framing may make a seemingly small relocation invasive.
  • Buying imported tapware without checking parts: A distinctive mixer is a poor bargain if cartridges, washers or replacement components can't be sourced locally.
  • Ordering too few tiles: A shortage during installation can force a different batch, a delayed job or an unwanted colour variation. Confirm the required quantity with the tiler before ordering.
  • Treating waterproofing certification as optional: Saving on documentation doesn't remove the technical risk, and it leaves a weaker project file for future sale or insurance discussions.
  • Paying for features that won't suit the room's life: A premium fitting may not justify its cost if the property's bathroom is likely to be redesigned again later.

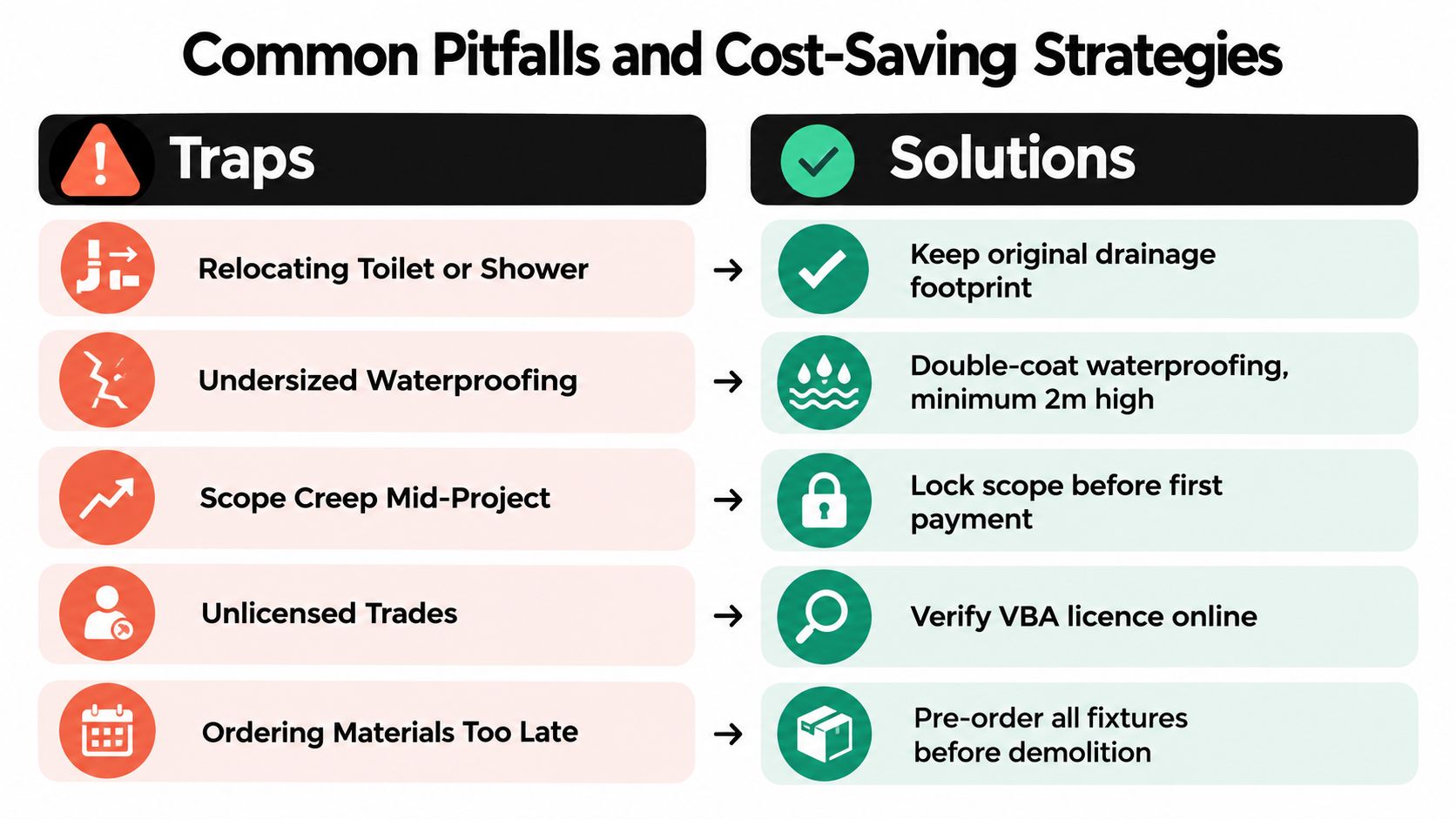

A chart showing common pitfalls and cost-saving strategies for renovating an ensuite bathroom or home space.

Where the savings are genuine

Keep the original plumbing footprint unless there's a sound structural or functional reason to move it. Choose a standard-size vanity instead of custom joinery where the room allows it. Large-format tiles can reduce visible grout and may reduce cutting and laying effort, provided the walls and floor are prepared accurately. A single mixer generally involves less hardware and installation complexity than a three-piece set.

Stage selections across two showroom visits. Make the functional decisions first, including shower type, toilet, vanity dimensions and tapware connections. Return for decorative choices once the core scope is stable. This prevents a showroom preference from becoming a site variation.

Budget discipline: Hold a contingency of 10% against the agreed scope, and keep it for concealed conditions rather than using it to fund mid-project upgrades.

Before demolition, organise a clean route for waste and protect adjoining floors. If the ensuite contents or nearby household items need to be moved, this guide to how to store items during remodelling offers practical preparation ideas.

Consultation Checklist and Final FAQ

Take a written checklist into the first in-home meeting. A capable tradesperson should be able to answer each point without relying on a vague lump-sum quote or verbal promises.

  • Proof of registration: Ask for current builder registration details.
  • VBA licence check: Verify the licence number through the Victorian Building Authority.
  • Itemised quote: Require labour, demolition, plumbing, electrical, waterproofing, tiling, fixtures and waste removal to be identified.
  • Waterproofing method: Ask which system will be used, where it will be applied and who will certify it.
  • Insurance certificate: Confirm the relevant insurance is current and covers the proposed work.
  • Written timeline: Record expected start and completion dates, along with material and glass dependencies.
  • Warranty statement: Clarify defect reporting, rectification responsibility and the applicable defect liability period.
  • Recent references: Request contacts for recent ensuite projects and ask those homeowners about communication, cleanliness and close-out.

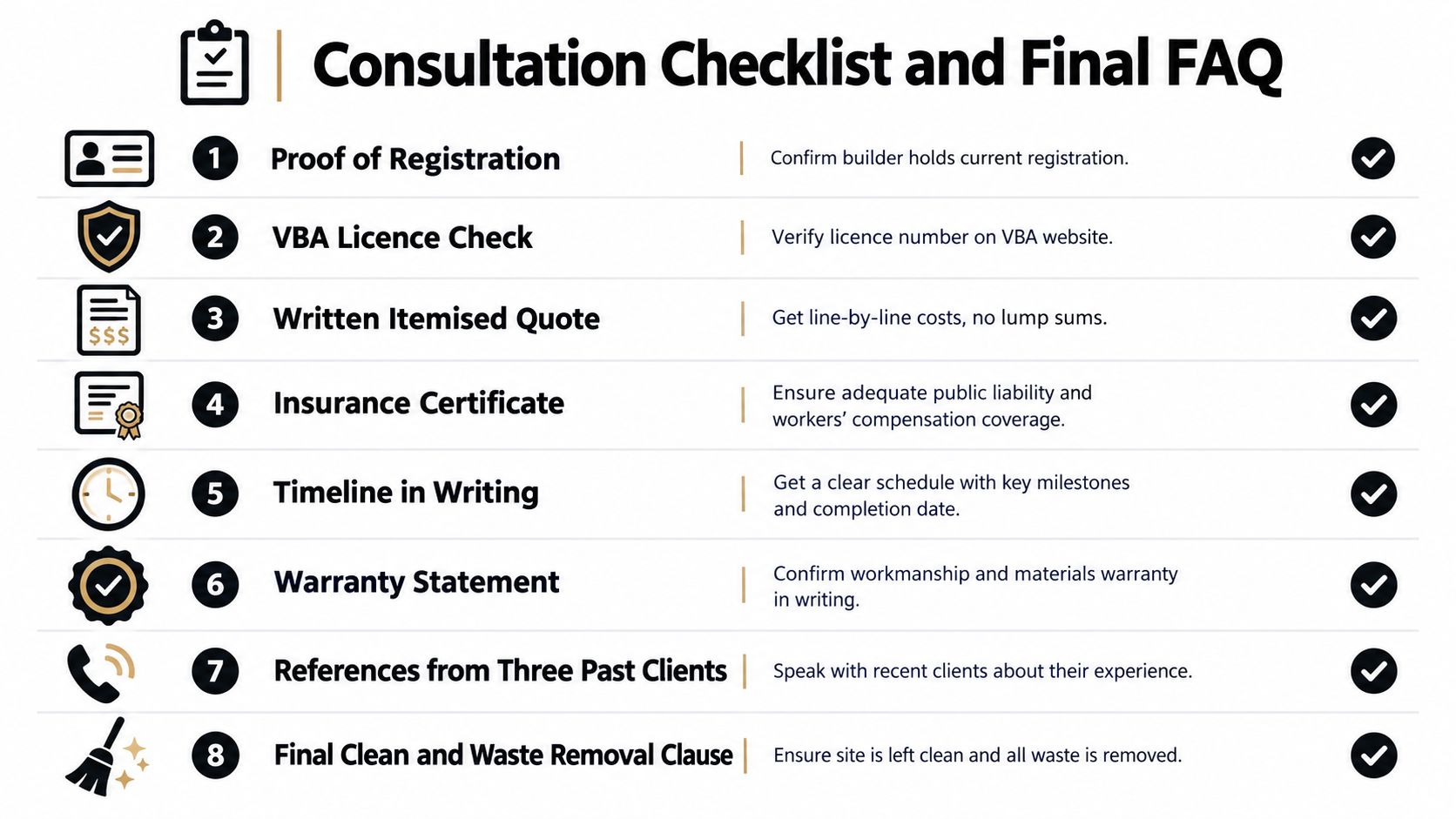

A checklist infographic outlining eight essential steps for consulting with a builder for home renovations.

Final questions homeowners ask

How long will the ensuite be unavailable? A controlled programme follows the trade order set out earlier, with curing, inspection and delivery gaps protected. Ask for a written schedule rather than accepting an optimistic verbal estimate.

Can the existing plumbing be reused? Often, yes, if the fixtures remain in a workable footprint and the existing pipes and wastes are sound. Confirm this after inspection, not from an inspiration drawing.

What approvals apply if walls are removed? The answer depends on whether the wall is structural and what building work is proposed. Have the builder identify approval requirements before demolition.

How should payments be staged? Tie payments to completed, inspectable milestones. Avoid paying for work that hasn't been installed, tested or documented.

What maintenance follows handover? Keep grout, sealant, tapware and stone care instructions with the compliance documents. Check junctions and silicone finishes during the handover inspection, and report defects in writing.

For a Melbourne homeowner, the safest ensuite bathroom remodel is not necessarily the one with the most expensive fittings. It's the one where the measurements, drainage, waterproofing, trade sequence and budget decisions agree before the first tile is removed.


Western Bathroom Renovations can manage an ensuite bathroom remodel across planning, demolition, waterproofing, tiling and final fit-off, with in-home consultation and written cost guidance for Melbourne homes. Review your layout, drainage footprint and compliance requirements with the team, then visit Western Bathroom Renovations to arrange the next step.
